Planning application · AGB/26/00300/SCREEN
Screening opinion sought for a 33kV overhead line spur at Allt Teanga Hydro.
Allt Teanga Hydro Glen More Isle Of Mull Argyll and Bute
Free preview. £1 a month for one alert. Cancel any time.
Preview alerts near your postcode
- Telecommunications
- Small 4/10
- Eia Screening
- Hydroelectric Power Station
- Kilovolt Voltage Category 33kv Overhead Line
- Spur Overhead Line Connection
Overview
- Proposed
- A 33kV overhead line spur
- Size
- 33 kV line voltage
- Stage
- Decided on 9 Apr 2026: Opinion Issued.
The council writes only to properties within 20 metres of an application site. Who is told
In plain English

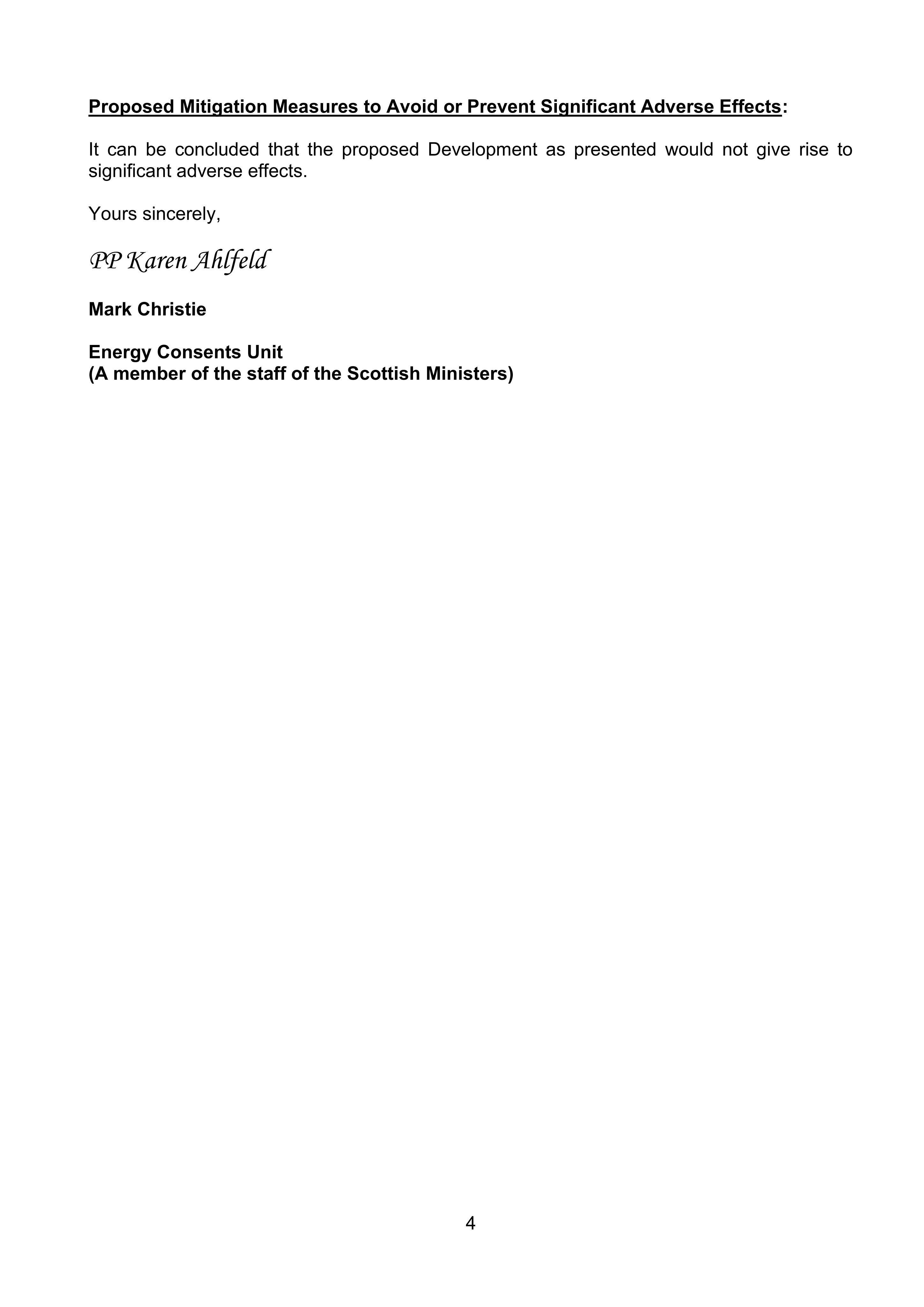

The application seeks a screening opinion for a 33kV overhead line spur at Allt Teanga Hydro on the Isle of Mull. A screening opinion is a decision on whether a project needs an environmental impact assessment. The portal records that an opinion was issued.
Written with AI from the application form and the council record.
Keep reading
Official records · coverage in progress
1,438 of 1,612 official records received 1 Sept 2025 – 31 Aug 2026 were available when checked on 6 Sept 2026. 174 records from that period are still being added or checked.
Proposals and decisions come from Argyll and Bute Council. Additional summaries and analysis are being added where verified.
Check the council’s planning registerTrack this application
How do I track planning application AGB/26/00300/SCREEN?
Follow it on City Scope. This page is checked against the Argyll and Bute Council planning register and shows the latest status, decision and documents for AGB/26/00300/SCREEN. City Scope can also email you when a new application is lodged nearby. To comment on the application, use the Argyll and Bute Council planning portal.
Set up a planning alertOn the street
What neighbours would notice.
- 01

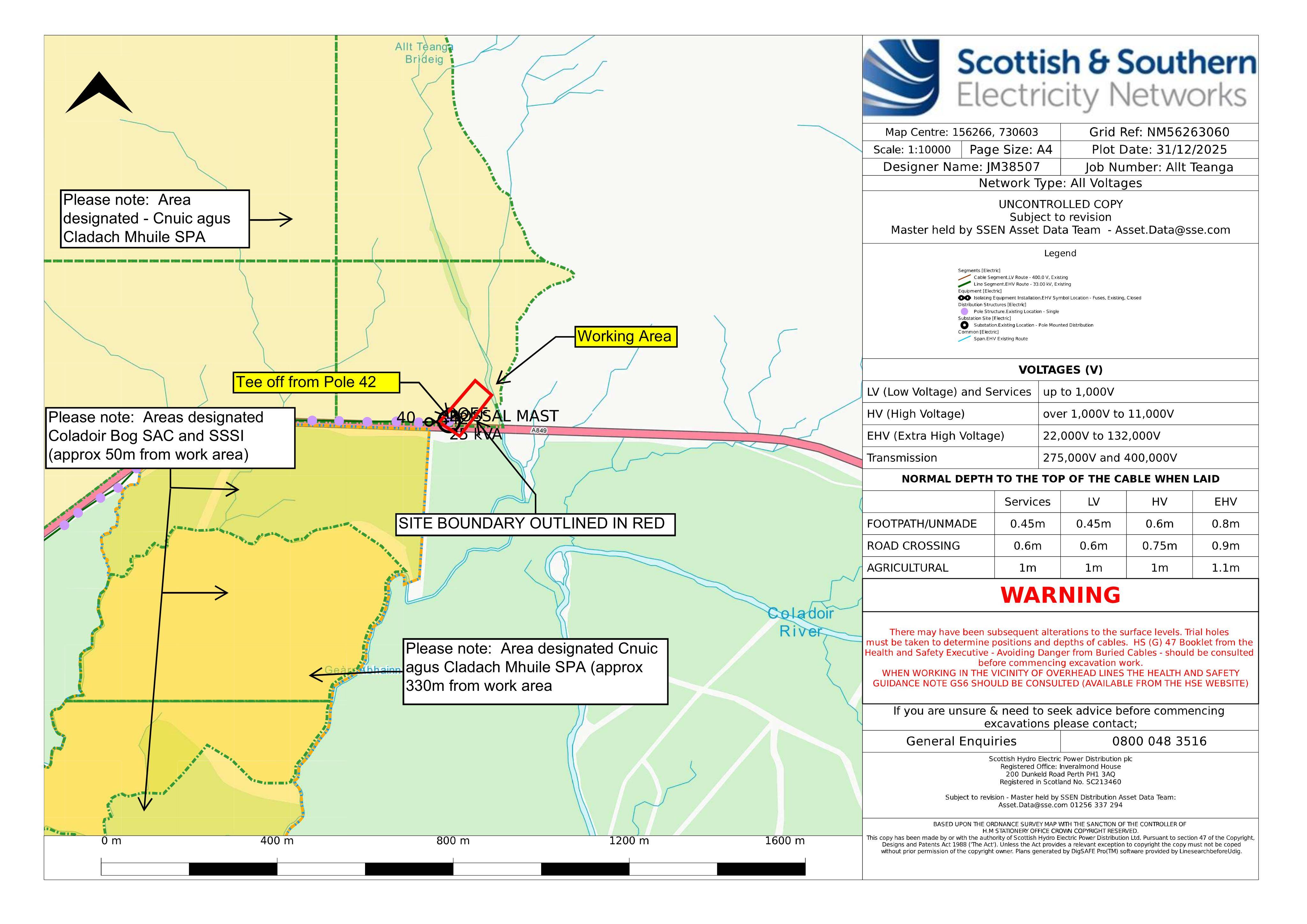

A 33kV overhead line spur is proposed; its route is not given in the description.
Questions
What does the screening opinion decide?
It decides whether the project needs an environmental impact assessment.
Has an opinion been issued?
The portal records that an opinion was issued.
From the application form
The application form
Every answer the applicant gave on the council’s form, searchable.
Tags
- Eia Screening
- Hydroelectric Power Station
- Kilovolt Voltage Category 33kv Overhead Line
- Spur Overhead Line Connection
What each tag is based on
- Eia Screening
- “Screening opinion”
- Hydroelectric Power Station
- “Allt Teanga Hydro”
- Kilovolt Voltage Category 33kv Overhead Line
- “33kV”
- Spur Overhead Line Connection
- “overhead line spur”
As lodged
The drawings.
All documents (4)
On the map
Open the planning map →© MapTiler / OpenFreeMap © OpenStreetMap contributors
Where it’s at
The council has decided on 9 April 2026.
- Received13 Feb 2026
- Validated13 Feb 2026The council has everything it needs.
- Comments closed6 Mar 2026Usual deadline. Late comments may still count.
- Target decision13 Apr 20262-month target for local developments.
- Decision9 Apr 2026Opinion Issued.
The record
- Reference
- AGB/26/00300/SCREEN
- Address
- Allt Teanga Hydro Glen More Isle Of Mull Argyll And Bute
- Status
- Unknown
- Council decision
- Opinion Issued
- Decision issued
- Category
- Telecommunications
- Impact scale
- 4/10
- Authority
- Argyll and Bute Council
- Received
- Validated
- Last checked
- Added to City Scope
Discussion
Talk about this application.
Share what you know about the site with other City Scope readers.
