Planning application · EAY/26/0036/AMCPP
Details approved for Lorg Wind Farm.
Lorg Wind Farm Between Carsphairn (approx 11km To South West) and Sanquhar (approx 12.3km To North East)
Free preview. £1 a month for one alert. Cancel any time.
Preview alerts near your postcode
- Legal / Administrative
- Minor 1/10
- Archaeology
- Condition Discharge
- Wind Turbine
Overview
- Proposed
- Approval of details required by the listed planning conditions
- Stage
- Decided on 2 Oct 2026: Approved.
The council writes only to properties within 20 metres of an application site. Who is told
In plain English

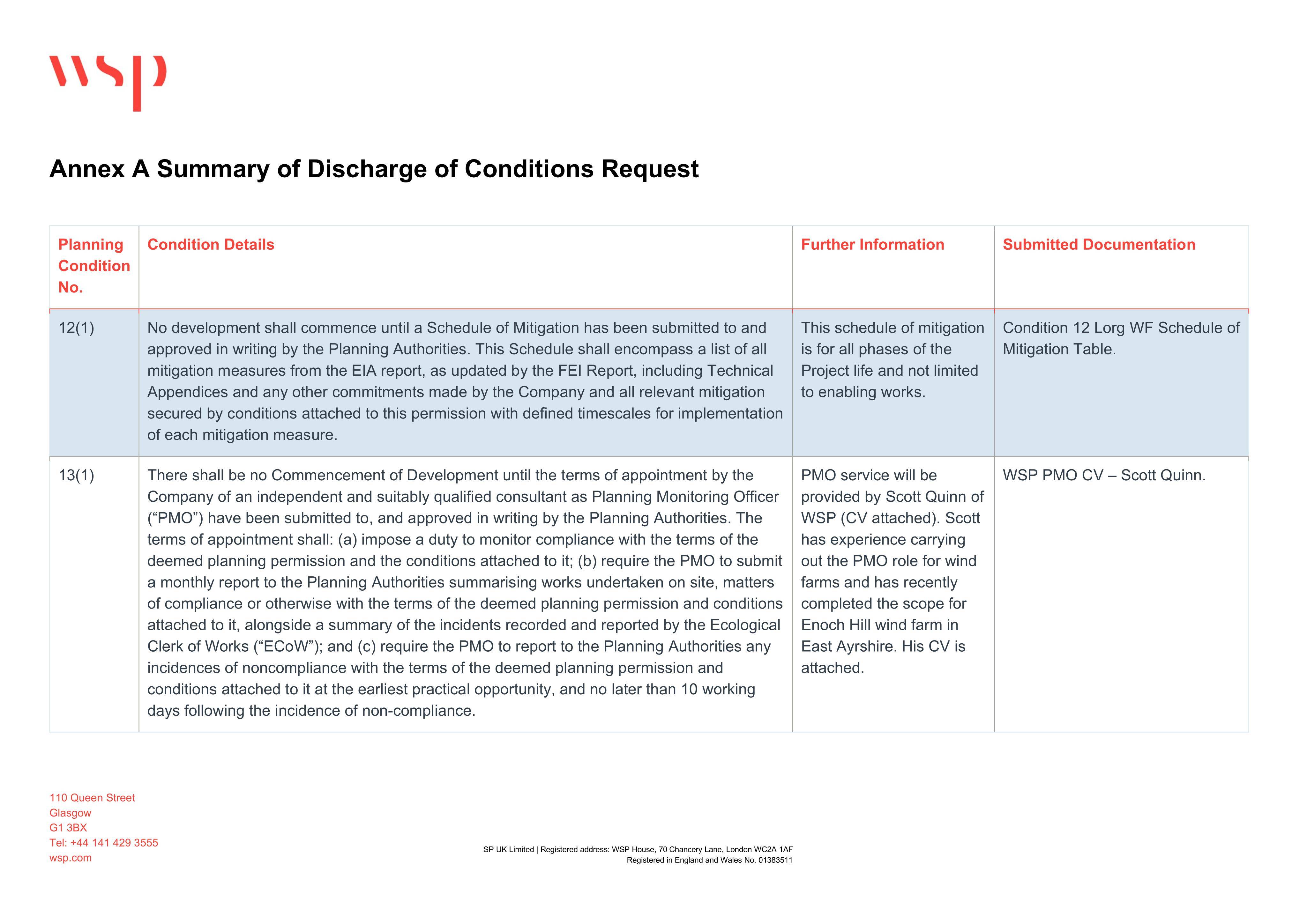

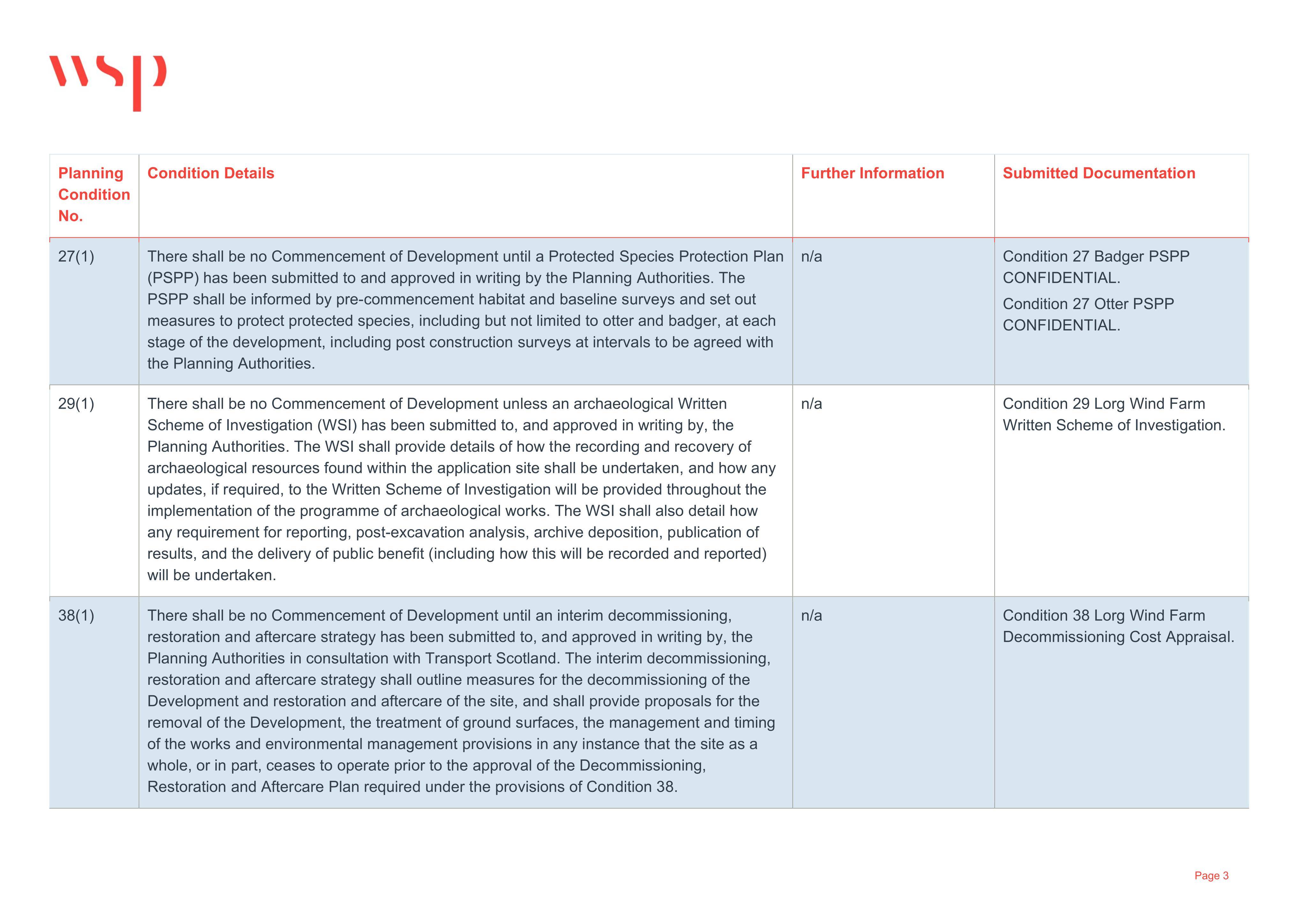

This application approves details for conditions attached to an already-approved scheme for Lorg Wind Farm. The conditions cover mitigation measures, a planning monitoring officer, a protected species plan, archaeological work, and an interim decommissioning, restoration and aftercare strategy.
Written with AI from the application form and the council record.
Keep reading
Official records · coverage in progress
621 of 673 official records received 1 Sept 2025 – 31 Aug 2026 were available when checked on 6 Sept 2026. 52 records from that period are still being added or checked.
Proposals and decisions come from East Ayrshire Council. Additional summaries and analysis are being added where verified.
Check the council’s planning registerTrack this application
How do I track planning application EAY/26/0036/AMCPP?
Follow it on City Scope. This page is checked against the East Ayrshire Council planning register and shows the latest status, decision and documents for EAY/26/0036/AMCPP. City Scope can also email you when a new application is lodged in this council area. To comment on the application, use the East Ayrshire Council planning portal.
Set up a planning alertThe impact
What the application says.
Questions
What does discharging a planning condition mean?
It means the council has approved details required by a condition attached to an earlier planning permission.
From the application form

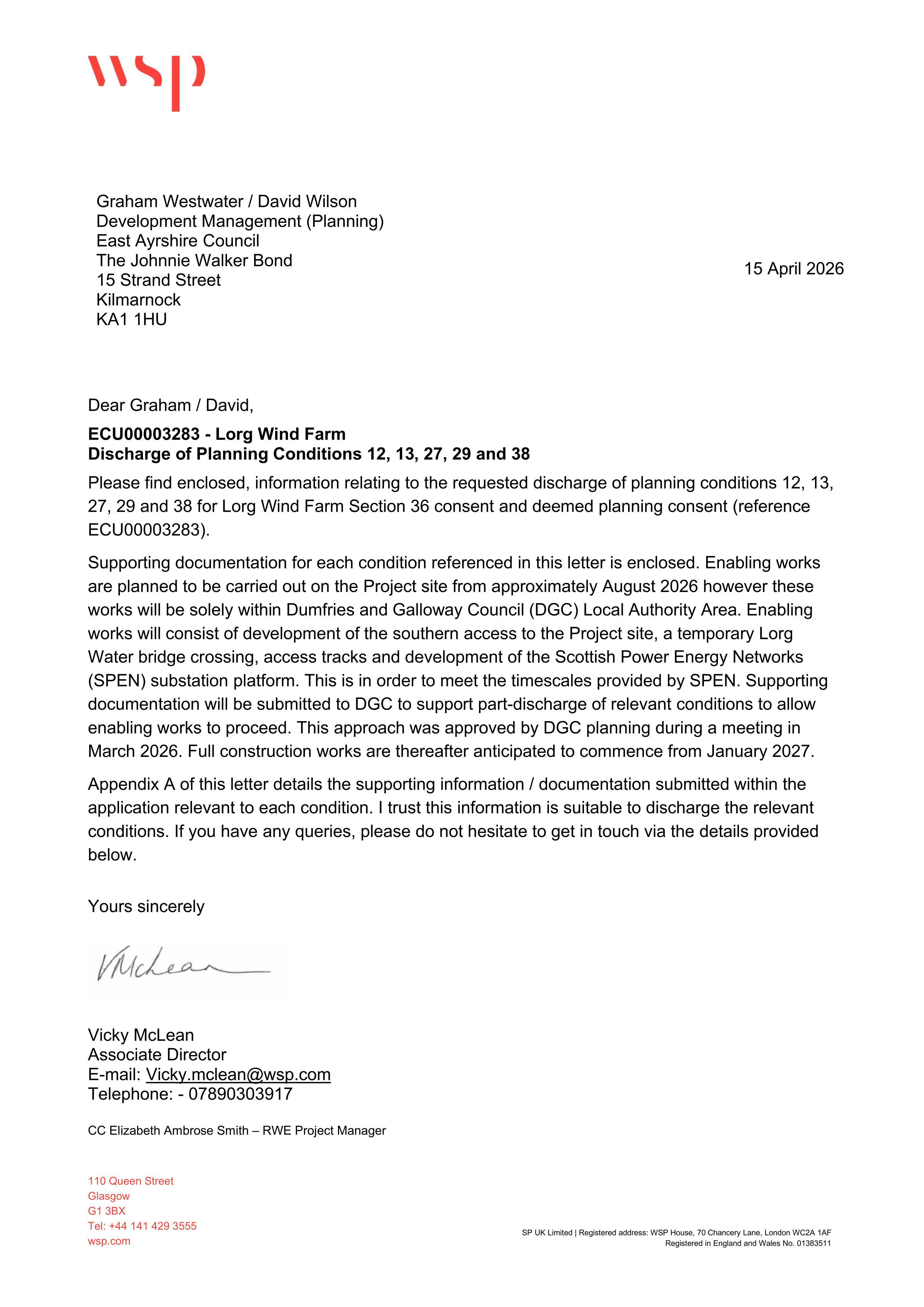

The application form
Every answer the applicant gave on the council’s form, searchable.
Tags
- Archaeology
- Condition Discharge
- Wind Turbine
What each tag is based on
- Archaeology
- “Programme of Archaeological Works”
- Condition Discharge
- “Discharge of planning conditions”
- Wind Turbine
- “Lorg Wind Farm”

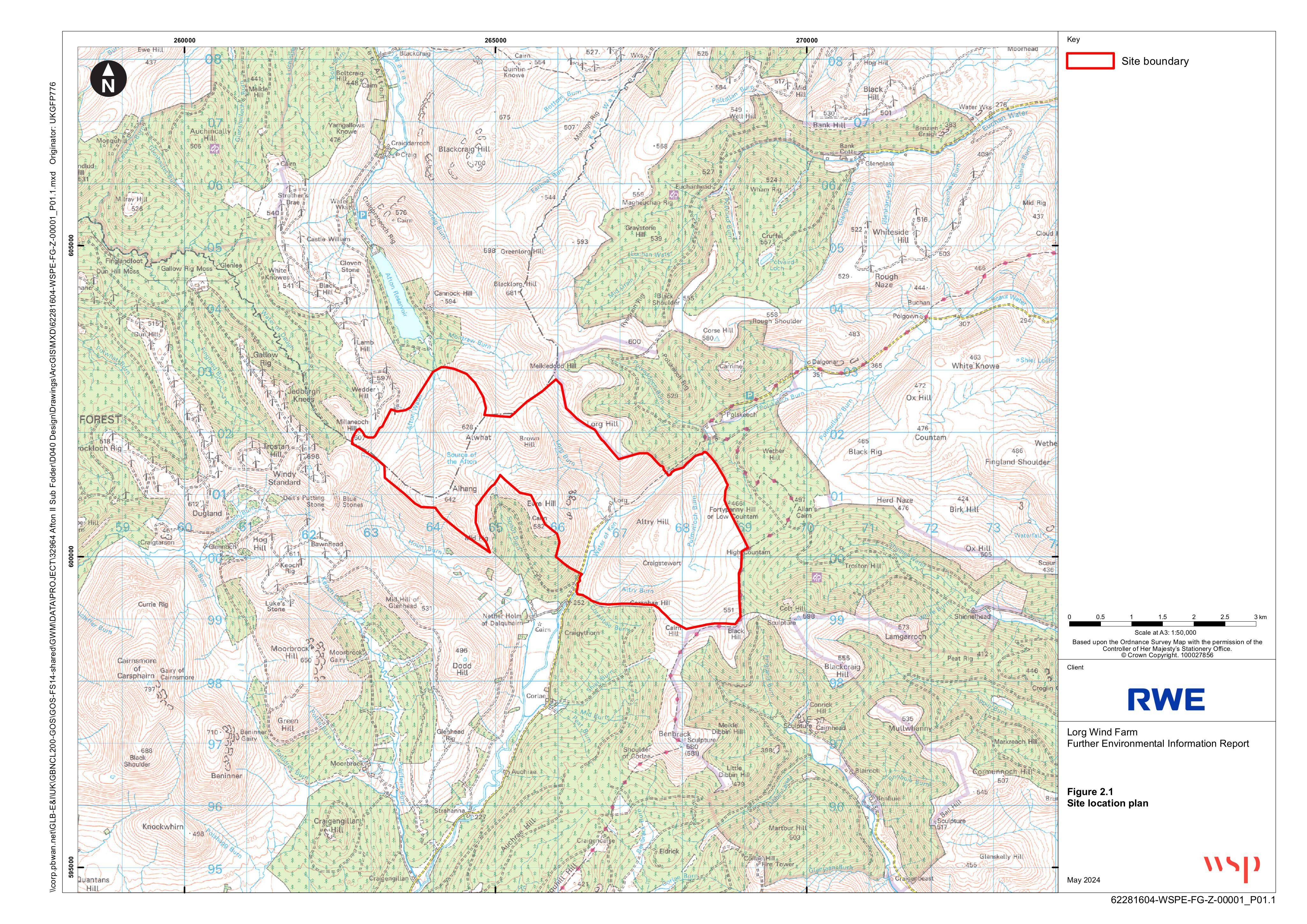

As lodged
The drawings.
Where it’s at
The council has decided on 2 October 2026.
- Received29 Apr 2026
- Validated30 Apr 2026The council has everything it needs.
- Comments closed21 May 2026Usual deadline. Late comments may still count.
- Target decision30 Jun 20262-month target for local developments.
- Decision2 Oct 2026Approved.
The record
- Reference
- EAY/26/0036/AMCPP
- Address
- Lorg Wind Farm Between Carsphairn (approx 11km To South West) And Sanquhar (approx 12.3km To North East)
- Status
- Decided
- Council decision
- Approved
- Decision issued
- Category
- Legal / Administrative
- Impact scale
- 1/10
- Authority
- East Ayrshire Council
- Received
- Validated
- Last checked
- Added to City Scope
Discussion
Talk about this application.
Share what you know about the site with other City Scope readers.
