Planning applicationPKC/26/00578/SCRN

Shindour Feddal Hill Wood Braco

DecidedWorth watchingNew-Build & Major Development
Official records · coverage in progress

1,141 of 1,475 official records received 1 Sept 2025 – 31 Aug 2026 were available when checked on 6 Sept 2026. 334 records from that period are still being added or checked.

Proposals and decisions come from Perth and Kinross Council. Additional summaries and analysis are being added where verified.

Check the council’s planning register
Planning document
1 / 4
Received

29 April 2026

Validated

25 May 2026

Planning Signals

7 detected traits

Works
HardstandingLandscaping
Specific
Associated InfrastructureCivil WorksDrainage Wastewater InfrastructureSubstation
Application Insights

No form insights available yet.

AI summary

Cambushinnie 400kV substation at Feddal Hill Wood: control building, plant, fencing, upgraded access incl ~1.2km haul track, bridge, drainage.

Impact scale

Estimated scale of impact on the surrounding area.

8/10
DISCUSSION

No comments yet

Be the first to share your local perspective on this application.

CityScope · Planning Updates

Application PKC/26/00578/SCRN

Shindour Feddal Hill Wood Braco

DecidedNew-Build & Major DevelopmentReceived Perth and Kinross Council

Cambushinnie 400kV substation at Feddal Hill Wood: control building, plant, fencing, upgraded access incl ~1.2km haul track, bridge, drainage.

Reference
PKC/26/00578/SCRN
Address
Shindour Feddal Hill Wood Braco
Status
Decided
Category
New-Build & Major Development
Impact scale
8/10
Authority
Perth and Kinross Council
Received
Validated
Last scraped
Record created
Latitude
56.2627
Longitude
-3.9416

Plain-language summary

Cambushinnie 400kV substation at Feddal Hill Wood: control building, plant, fencing, upgraded access incl ~1.2km haul track, bridge, drainage.

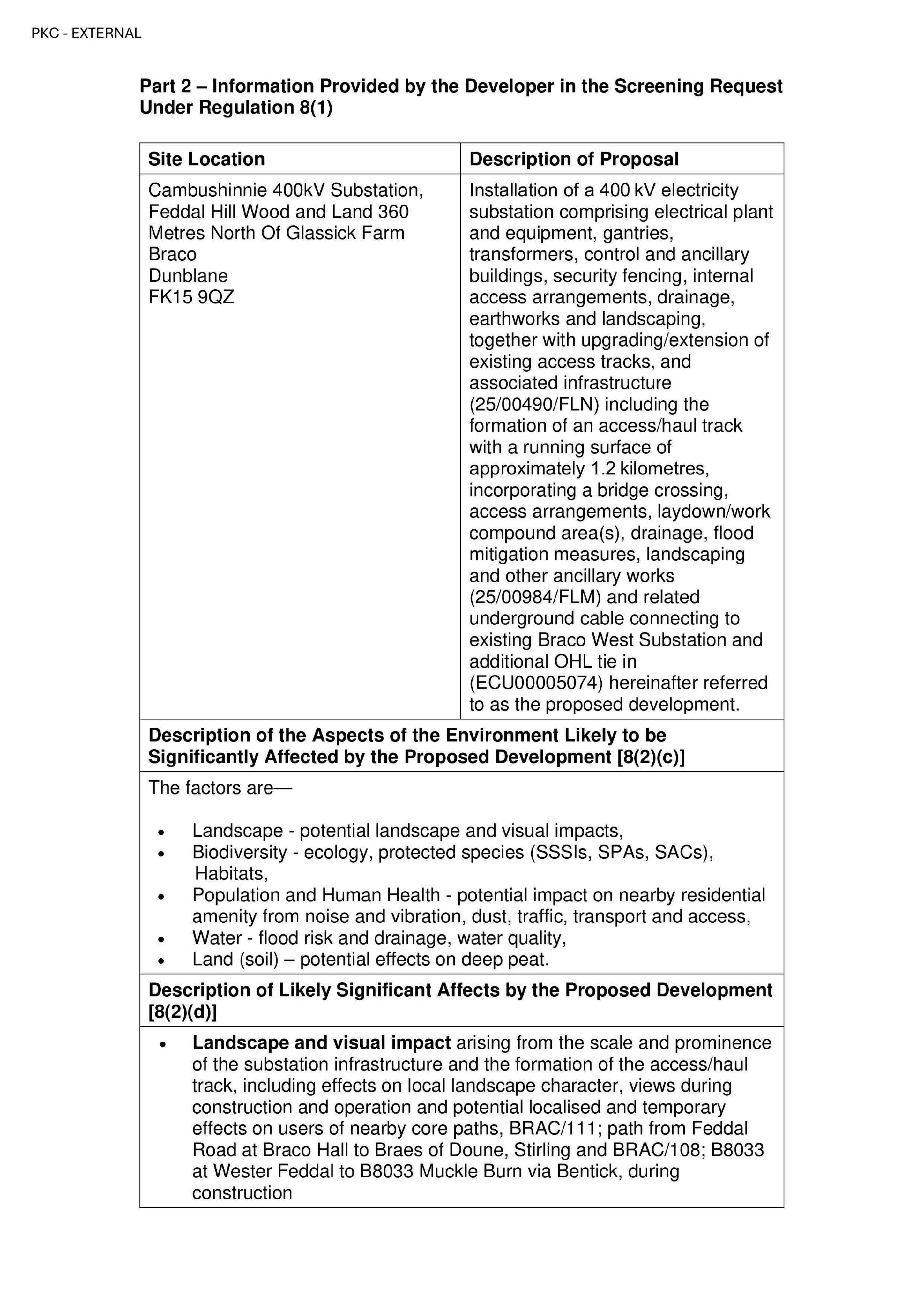

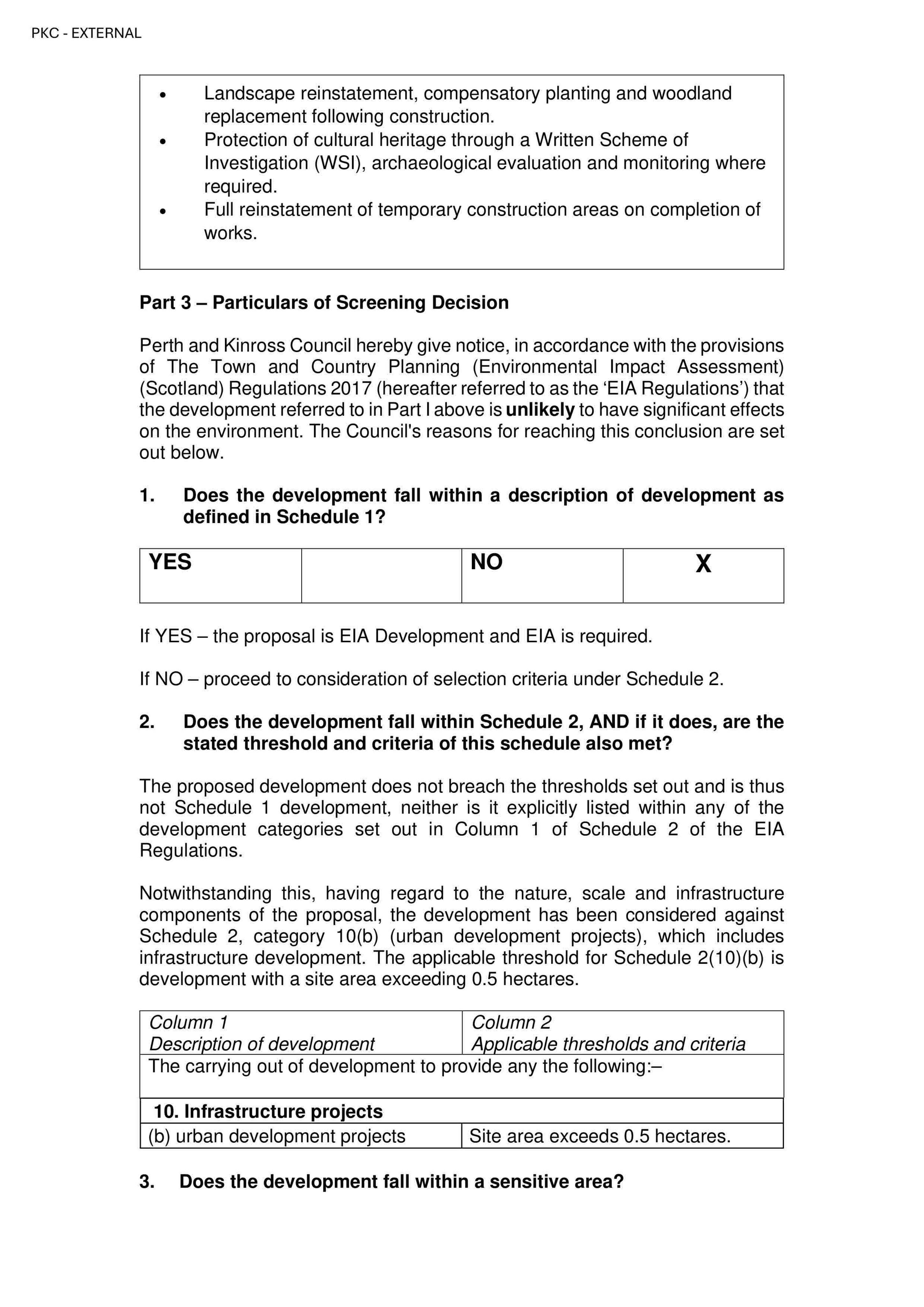

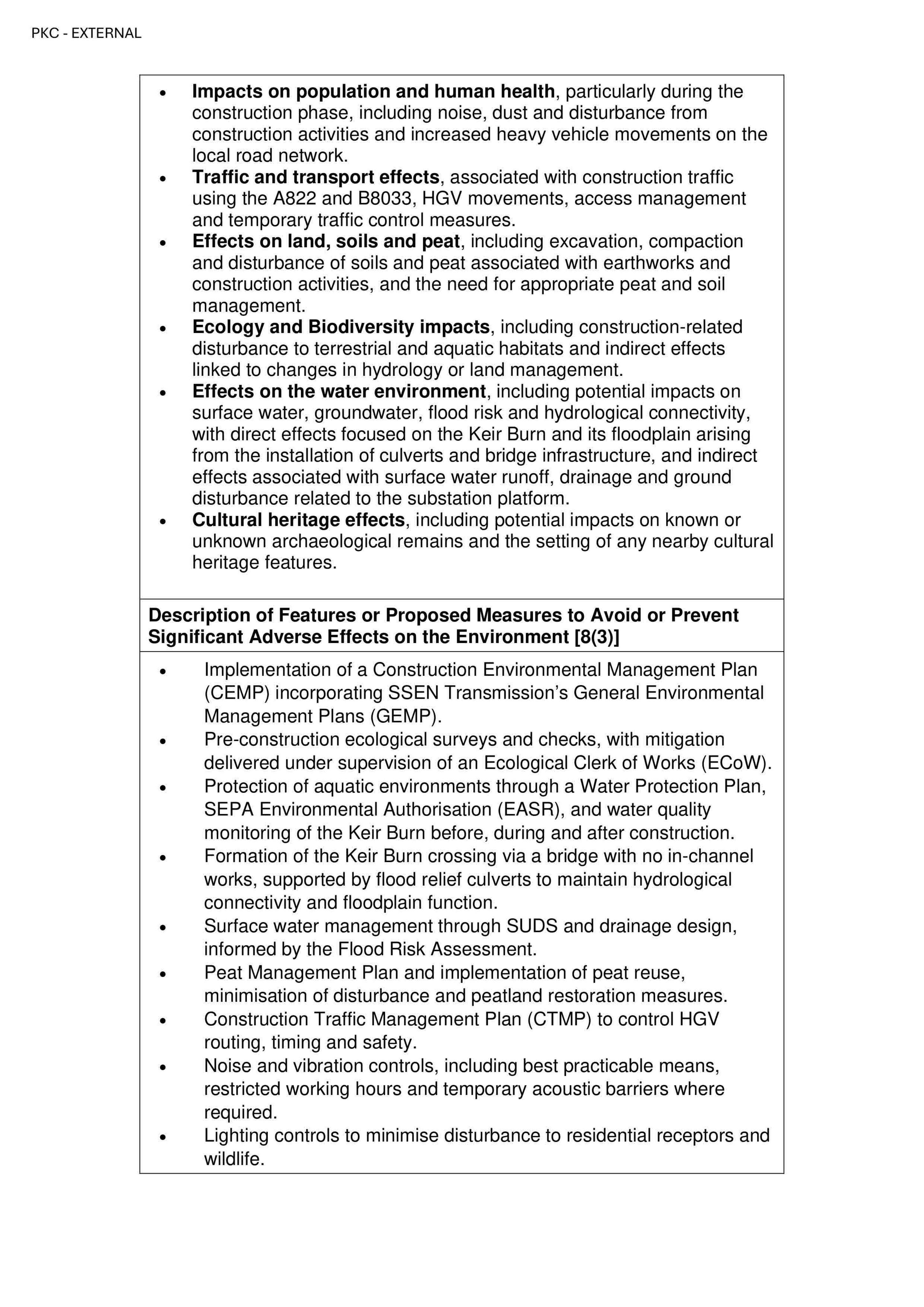

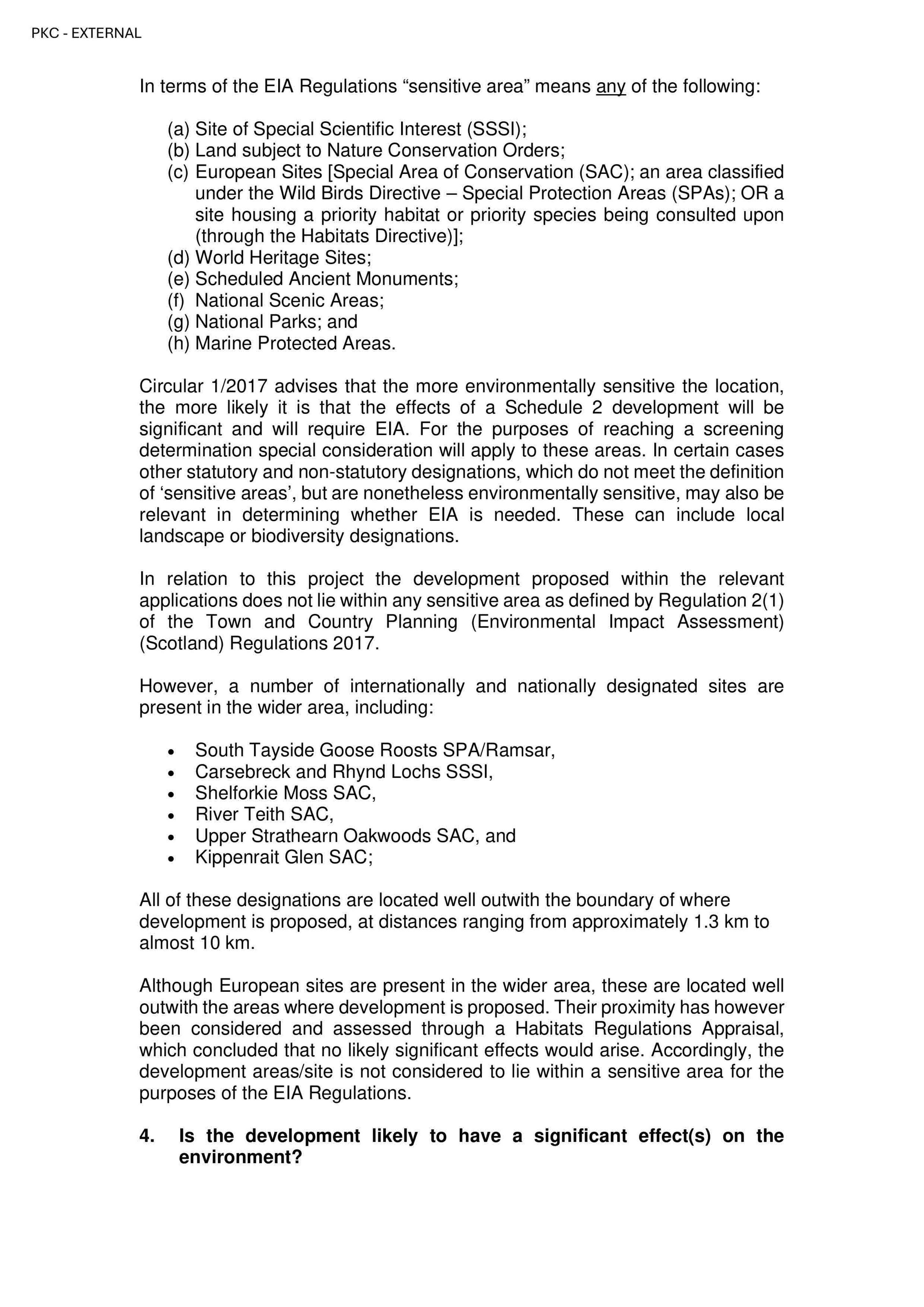

As filed with the council

Formation of 400kV substation comprising erection of control building, engineering operations, formation of hardstanding, access track, temporary laydown/work compound areas and drainage, installation of plant and machinery, alterations to existing track and associated works and formation of a track comprising a running surface of approximately 1.2 kilometres in length, bridge, access, laydown/work compound area(s), drainage, landscaping and other ancillary works
